The order a segmental retaining wall goes together
A segmental wall goes together over time, not in layers added at the end: excavate a level trench, compact a stone base and bury the first course, then stack courses with a setback while the drainage stone, pipe and geogrid rise with the wall, and finish with glued caps, filter fabric, and grade pitched away.
What this diagram shows

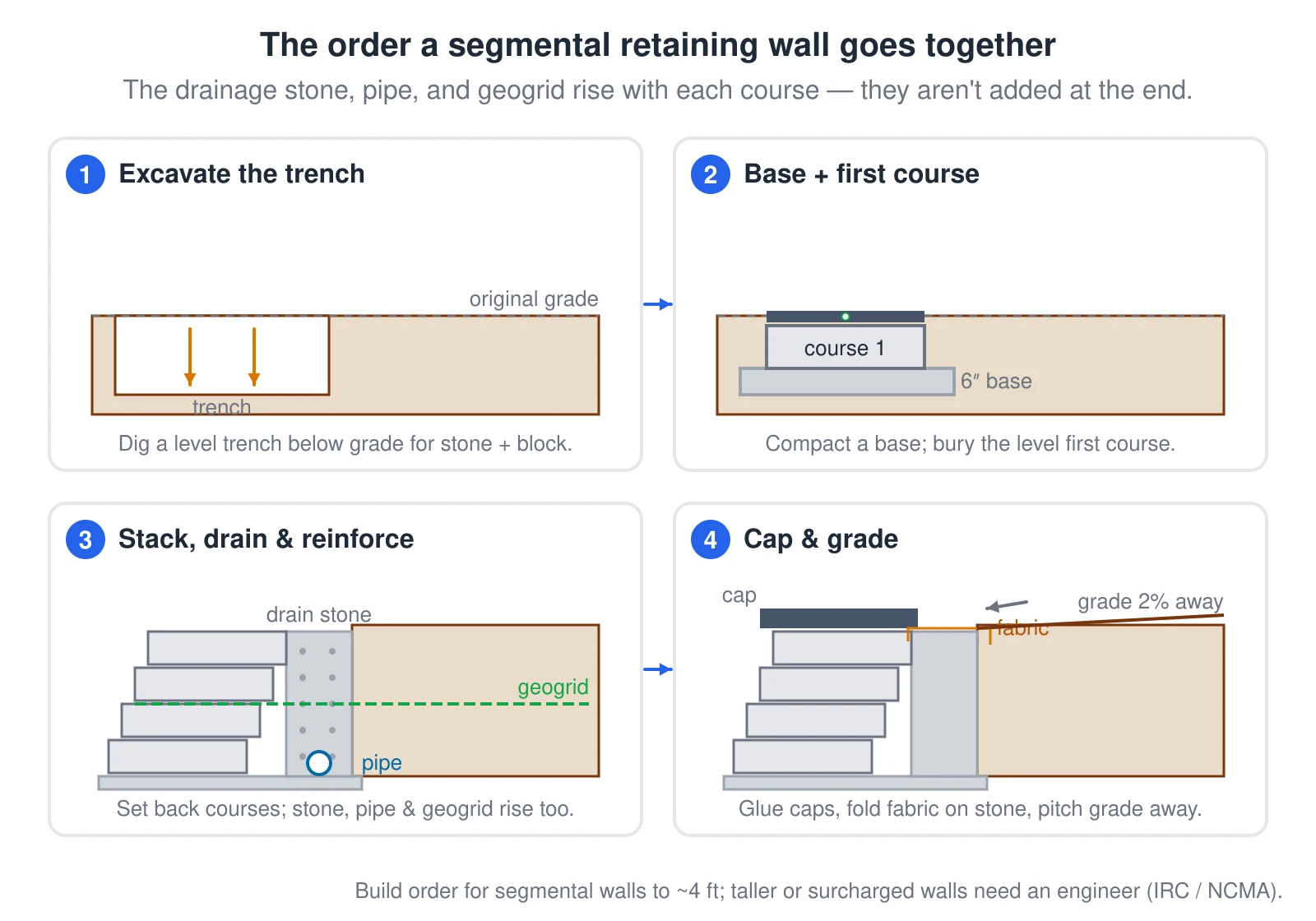

A four-panel walkthrough of the segmental retaining-wall build order in cross-section. Panel 1: a level trench is excavated below grade, wide enough for drainage stone behind the block line. Panel 2: a compacted stone base is placed and the first course of block is leveled and buried below grade. Panel 3: courses are stacked with a setback while a drainage-stone chimney, a perforated pipe at the base, and geogrid reinforcement into the retained soil rise with each course. Panel 4: capstones are glued on with a front overhang, filter fabric is folded over the top of the stone, and the finish grade is pitched away from the wall.
Use this diagram — free
You're welcome to use this diagram on your own site, blog, handout, or lesson at no cost. The only condition is a visible credit link back to the source page. Copy the snippet below and paste it into your page — the credit is already included.
Please keep the credit link intact and don't alter the diagram itself. Redistribution as part of a competing diagram library or template pack isn't permitted. Questions? Reach us via the site.
Related diagrams
- Foundations & Drainage
Retaining wall cross-section — base, buried course, batter, drainage gravel, and pipe
- Foundations & Drainage
Why retaining walls fail — hydrostatic pressure without drainage
- Foundations & Drainage
Retaining wall geogrid reinforcement and when an engineer is required
- Foundations & Drainage
French drain slope — 1% (1/8 inch per foot) minimum fall to daylight
- Foundations & Drainage
French drain filter fabric — burrito wrap vs sock vs none
